The Adoption of the Solar Exclusion Norm
Government Notice 4558 of 2024 (Gazette No. 50388, 27 March 2024). The Minister of Forestry, Fisheries and the Environment adopted the Solar Exclusion Norm in terms of section 24(10) of NEMA — creating a faster, simplified pathway for qualifying solar PV projects.
Read the gazetted notice
Government Notice 4558 of 2024 — the official NEMA Solar Exclusion Norm (PDF).
A registration pathway, not an EIA
The Norm sets out the rules under which solar PV facilities in Low or Medium sensitivity areas are excluded from needing an Environmental Authorisation before commencement — while still meeting the objectives of the Act.
The Minister's adoption
This is not an EIA
Five things the Norm establishes
Applicable to
Sensitivity requirement
What is excluded?
What is required?
Timeframe
Only Low or Medium sensitivity qualifies
The national web-based Screening Tool rates environmental sensitivity across themes such as plant species, animal species, terrestrial and aquatic biodiversity, and agriculture. The exclusion applies only where the whole site is Low or Medium.
A pre-negotiated linear-infrastructure corridor (max 200 m wide) may cross higher-sensitivity land under strict conditions — but the facility footprint itself must remain in Low or Medium areas.
The Solar Exclusion Norm at a glance

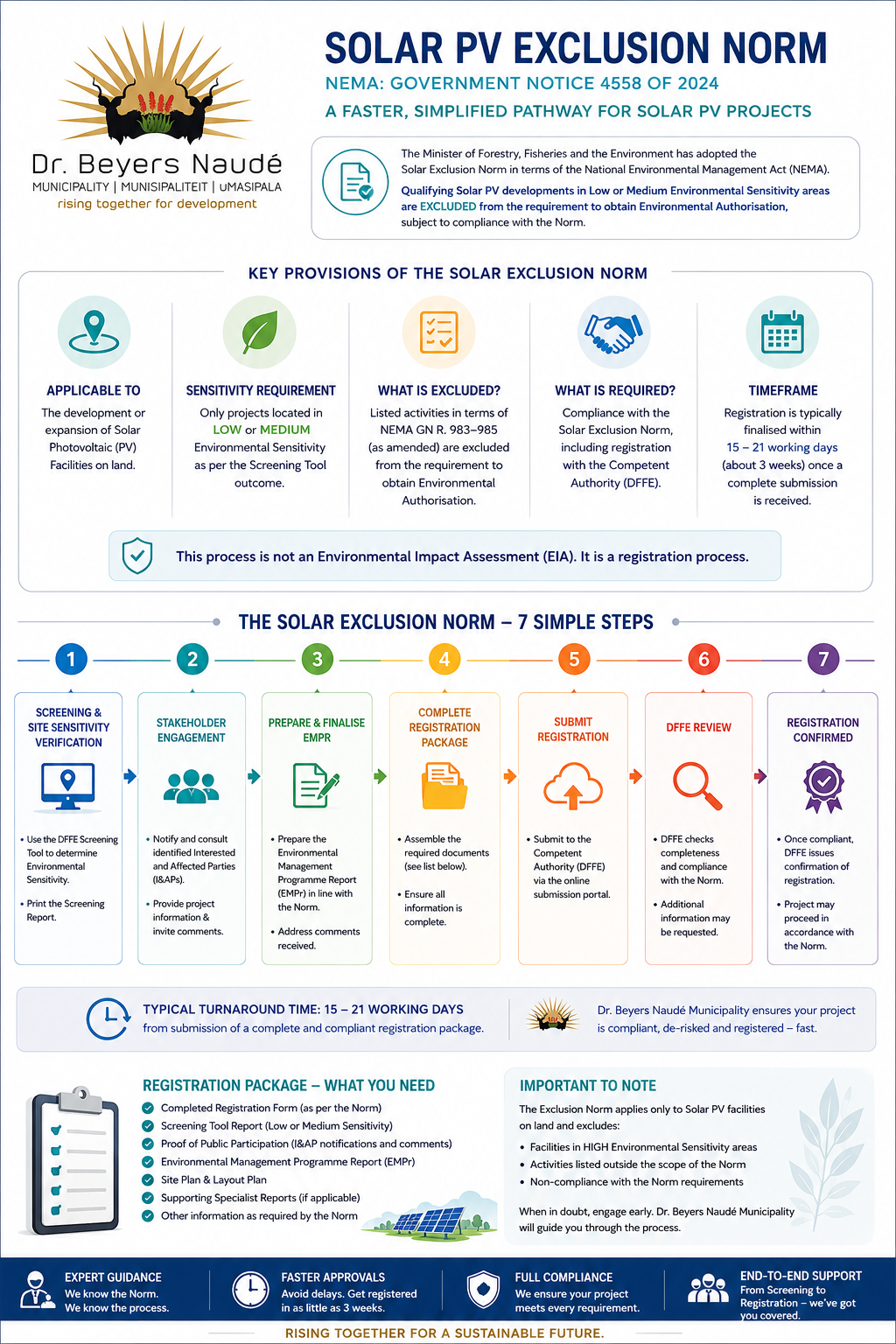

The Dr Beyers Naudé infographic summarising Government Notice 4558 of 2024 — its provisions, the 7-step process and the registration package.

The Solar Exclusion Norm — 7 simple steps
From screening through to confirmed registration. Each step builds the compliant package the Competent Authority needs.
- 1
Screening & site sensitivity verification
Use the DFFE Screening Tool to determine environmental sensitivity and print the screening report.
- 2
Stakeholder engagement
Notify and consult Interested & Affected Parties (I&APs); provide project information and invite comments.
- 3
Prepare & finalise EMPr
Prepare the Environmental Management Programme Report in line with the Norm and address comments received.
- 4
Complete registration package
Assemble all required documents and ensure the information is complete.
- 5
Submit registration
Submit to the Competent Authority (DFFE) via the online submission portal.
- 6
DFFE review
DFFE checks completeness and compliance with the Norm; additional information may be requested.
- 7
Registration confirmed
Once compliant, DFFE issues confirmation and the project may proceed in accordance with the Norm.
The registration package
- Completed Registration Form (Appendix A of the Norm)
- Screening Tool Report (Low or Medium sensitivity)
- Proof of Public Participation (I&AP notifications & comments)
- Environmental Management Programme Report (EMPr)
- Site Plan & Layout Plan
- Supporting Specialist Reports (where applicable)
- Other information as required by the Norm
Important to note
Battery storage is included here
See it applied to a real project
Tab 3 shows the design of our first 25 MWp plant at Adendorp and the Graaff-Reinet BESS.
